Meeting of the Clifton to Tangoio Coastal Hazards Strategy Joint Committee

Date:                       22 February 2022

Time:                      10.00am

Venue:

Council Chamber

Hawke's Bay Regional Council

159 Dalton Street

NAPIER

Agenda

Item          Title                                                                                                                                           Page

1.            Welcome/Notices/Apologies

2.            Conflict of Interest Declarations

3.            Confirmation of Minutes of the Clifton to Tangoio Coastal Hazards Strategy Joint Committee meeting held on 19 November 2021

4.            Actions from Previous Clifton to Tangoio Coastal Hazards Strategy Joint Committee Meetings                                                                                3

5.            Call for Minor Items Not on the Agenda                                                        7

Information or Performance Monitoring

6.            Communication and Engagement Update                                                    9

7.            Project Manager's Update                                                                              15

8.            Verbal Current Coastal Projects Update                                                      17

9.            Coastal Ecology Workstream                                                                          19

10.          Discussion of Minor Matters Not on the Agenda                                      71

Clifton to Tangoio Coastal Hazards Strategy Joint Committee

22 February 2022

SUBJECT: Actions from Previous Clifton to Tangoio Coastal Hazards Strategy Joint Committee Meetings

Reason for Report

1.        To track items raised at previous meetings that require action, a list of outstanding items is prepared for each meeting. All action items indicate who is responsible for each, when it is expected to be completed and a brief status comment.

2.        Once the items have been completed and reported to the Committee they will be removed from the list.

Decision Making Process

3.        Staff have assessed the requirements of the Local Government Act 2002 in relation to this item and have concluded that, as this report is for information only, the decision-making provisions do not apply.

Recommendation

That the Clifton to Tangoio Coastal Hazards Strategy Joint Committee receives and notes the “Actions from previous Clifton to Tangoio Coastal Hazards Strategy Joint Committee meetings” report.

Authored by:

Simon Bendall

Coastal Hazards Strategy Project Manager

Approved by:

Chris Dolley

Group Manager Asset Management

Attachment/s

1

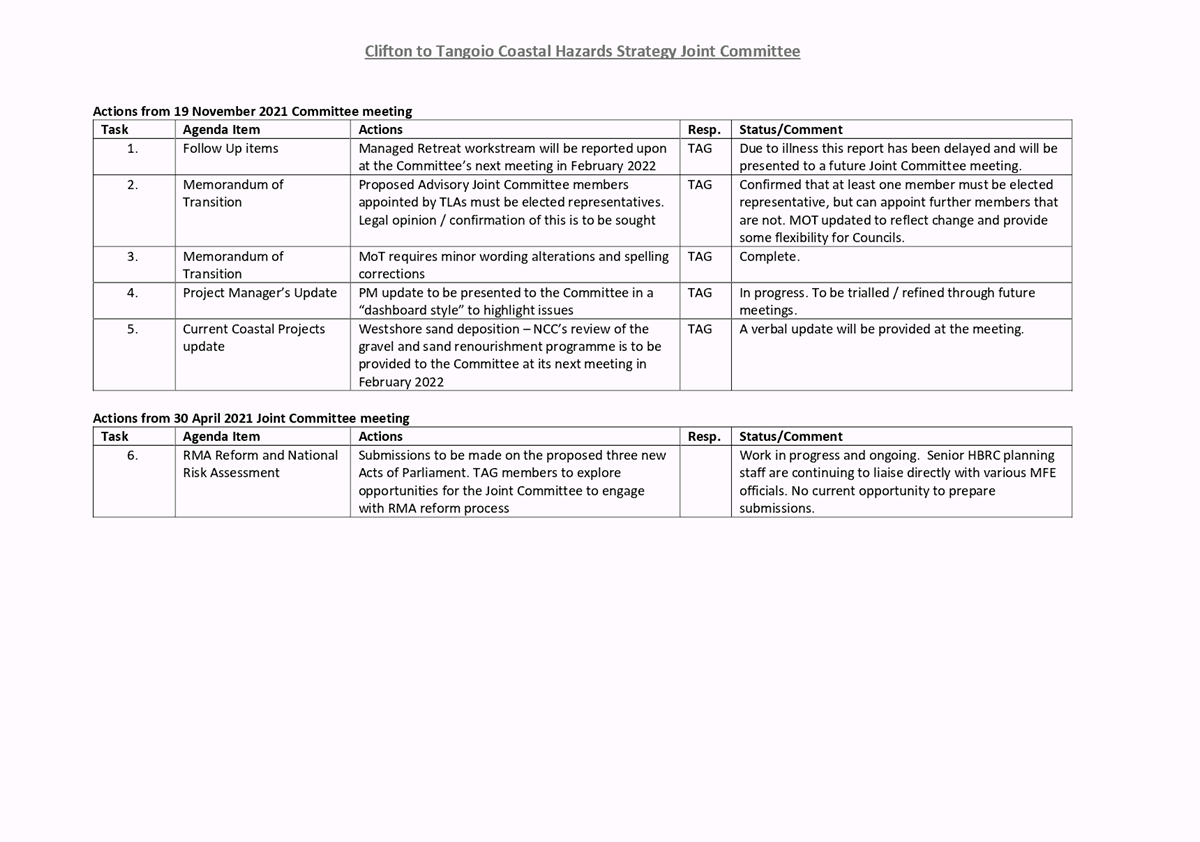

Actions from previous Clifton to Tangoio Coastal Hazards Strategy Joint Committee meetings

Actions from previous Clifton to Tangoio Coastal Hazards Strategy Joint Committee meetings

Attachment 1

PDF Creator

Clifton to Tangoio Coastal Hazards Strategy Joint Committee

22 February 2022

Subject: Call for Minor Items not on the Agenda

Reason for Report

1.        This item provides the means for Joint Committee members to raise minor matters they wish to bring to the attention of the meeting.

2.        Hawke’s Bay Regional Council standing order 9.13 states:

2.1.     A meeting may discuss an item that is not on the agenda only if it is a minor matter relating to the general business of the meeting and the Chairperson explains at the beginning of the public part of the meeting that the item will be discussed. However, the meeting may not make a resolution, decision, or recommendation about the item, except to refer it to a subsequent meeting for further discussion.

Recommendations

3.        That the Clifton to Tangoio Coastal Hazards Strategy Joint Committee accepts the following “Minor Items Not on the Agenda” for discussion as Item 10.

Topic

Raised by

Leeanne Hooper

GOVERNANCE TEAM LEADER

James Palmer

CHIEF EXECUTIVE

Clifton to Tangoio Coastal Hazards Strategy Joint Committee

22 February 2022

Subject: Communication and Engagement Update

Reason for Report

1.        This report gives a brief overview of communications and engagement that has happened since the last Joint Committee meeting in November 2021. It outlines the changes to our proposed timing for engaging with the wider community ahead of formal consultation in May 2022 and seeks advice on the process of engaging with mana whenua.

Executive Summary

2.        Communications and engagement for the Strategy has once again slowed due to Covid-19 postponing our final panel workshop and limiting engagement opportunities. The timing for the community and Council-led pre-engagement activity proposed at the November Joint Committee meeting has changed to ensure we deliver an effective engagement approach.

Discussion

3.        A digital workshop with the community on 8 December 2021 discussed community-led engagement and sought feedback on a draft survey for the community and associated information sheet. Feedback from the community was positive, and they suggested that the engagement occur in the first quarter of 2022, rather than trying to push it through prior to Christmas.

4.        Our last planned community workshop was held in person on 2 February 2022, focussing on community engagement, and was the second workshop looking at the approach to developing signals, triggers and thresholds for the adaptive pathways developed under the Strategy. It was agreed at the workshop to combine community and council pre-engagement which will kick off at the end of February.

5.        This initial engagement will be a digital-first warm up ahead of formal consultation and will involve a survey (attached) that will be shared to the community through our mailing database, on council websites and social media pages, and through the community members.

6.        The primary purpose of the engagement and survey is to reconnect with the community (it has been some years since any form of targeted engagement has occurred with the wider community), inform them of our work, and gain some high-level feedback to guide future engagement and project development.

7.        A newsletter update is scheduled to go out at the end of February and will feature the community engagement, community workshops, and this Joint Committee meeting.

8.        The Strategy continues to track towards a wider public consultation process in the first half of 2022, which would be seeking to confirm the role of HBRC in Strategy implementation.

9.        For consultation, we will be using social pinpoint, a map-based online consultation and engagement tool. The tool allows us to be place-specific when sharing information with the community and seeking feedback, e.g. going into detail about the coastal hazard risks and proposed management solutions at Te Awanga. This is the same tool HBRC are using for their Kotahi engagement.

10.      There are no further changes to report following our update to the Joint Committee in November on mana whenua engagement. There has been limited uptake/responses to approaches and information provided as part of the engagement strategy. We are mindful of many competing priorities for mana whenua at this time, and we are seeking the committee’s advice on any further steps that can or should be taken to engage ahead of consultation in the middle of this year.

Next Steps

11.      The key next step is council pre-engagement.

Decision Making Process

12.      Staff have assessed the requirements of the Local Government Act 2002 in relation to this item and have concluded that, as this report is for information only, the decision-making provisions do not apply.

Recommendation

That the Clifton to Tangoio Coastal Hazards Strategy Joint Committee receives and notes the “Communication and engagement update” staff report.

Authored by:

Rebecca Ashcroft

Communications Advisor

Simon Bendall

Coastal Hazards Strategy
Project Manager

Approved by:

Chris Dolley

Group Manager Asset Management

Attachment/s

1

HB Coast:  Survey Questions

HB Coast:  Survey Questions

Attachment 1

PDF Creator

PDF Creator

PDF Creator

Clifton to Tangoio Coastal Hazards Strategy Joint Committee

22 February 2022

Subject: Project Manager's Update

Reason for Report

1.        This report provides an update on project-related matters including timeframes, budgets and tracking towards milestones.

2.        Subject to key project related matters arising, this report is usually provided as a verbal update. However, going forward the Joint Committee has requested dashboard-style reporting on key project elements.

Project Dashboard

3.        The following project dashboard is provided to summarise current project status, and as a first test of this approach to determine usefulness and clarity for Joint Committee members. Further refinement to the reporting method can be made in response to feedback.

4.        The dashboard presents project budget and timeline and all 8 active workstreams (WS). An assessment of each project element is made on a ‘traffic light’ basis, with a brief commentary provided to explain the rating given.

Project Dashboard Report: February 2022

Metric

Status

Commentary

Project Budget

On track for 2021-2022 financial year

Project Timeline

Extended Strategy adoption / imp. timeframes

WS1: Funding / Governance

2/5 Councils have approved MOT– others pending

WS2: LGA Consultation

Target May / June – many moving parts

WS3: Comms & Engagement

COVID impacts. Mana Whenua engagement low

WS4: Design

Substantially complete

WS5: Managed Retreat

Sig. delayed. Expected next JC meeting

WS6: Coastal Ecology

Gap analysis complete. Planning next steps

WS7: Regulatory

Target HBRC + NCC plans – significant work coming

WS8: Signals and Triggers

3 workshops held. Now in write-up / testing

Status:

Key risk

Under stress

On track

5.        The key focus and priority for TAG at this stage is confirming the Memorandum of Transition (MOT) to enable the commencement of the s.16 process by HBRC (WS1 & WS2). There are many moving parts, particularly confirming support from all 5 councils in the region. It is a major focus to complete this process within the current triennium.

6.        The only key risk (red) rating given at this time is for Project Timeline. This is in response to the length of time taken to progress the project from the delivery of the Assessment Panel recommendations, to completing and notifying a proposed Strategy as a confirmed proposal from project partners.

7.        While good progress has been made on confirming roles and responsibilities for implementation (i.e. the MOT), this work is ongoing and is a key barrier to progressing to the substance of implementation.

8.        The draft MOT includes as Schedule Two an indicative project timeline, key elements of which are replicated below for reference:

“Subject to HBRC adopting amendments to its Long-Term Plan to give effect to the Proposal:

I.     HBRC shall consult on the proposed Clifton to Tangoio Coastal Hazards Strategy as a non-statutory policy document and shall seek to adopt a final Strategy by 31 March 2023.

II.    The Parties shall prepare and execute the Asset Transfer Agreement by 1 July 2023.

III.  The Clifton to Tangoio Costal Hazards Strategy Joint Committee shall be disestablished on 30 June 2024.

The Advisory Committee shall be established from 1 July 2024.

IV.  The transfer of assets in accordance with the Asset Transfer Agreement shall occur by 1 July 2024.

V.   HBRC shall confirm funding arrangement for implementing physical works under the Strategy in its 2024 – 2034 Long Term Plan.”

9.        This timeline was prepared to provide a conservative endpoint for each step, in the expectation that matters could be completed earlier. However, concluding the Funding Review / MOT process has taken longer than anticipated, and noting local body elections in October 2022, this timeframe is under pressure.

Recommendation

That the Clifton to Tangoio Coastal Hazards Strategy Joint Committee receives the “Project Managers Update” report.

Authored by:

Simon Bendall

Coastal Hazards Strategy Project Manager

Approved by:

Chris Dolley

Group Manager Asset Management

Attachment/s

There are no attachments for this report.

Clifton to Tangoio Coastal Hazards Strategy Joint Committee

22 February 2022

Subject: Current Coastal Projects Update

Reason for Report

1.        This report provides an opportunity for the Technical Advisory Group (TAG) to provide an update on various coastal projects the Joint Committee has expressed an interest in keeping abreast of, namely:

1.1.         Whakarire Ave Revetment Works

1.2.         Extended consent area for sand deposition at Westshore

1.3.         Haumoana 18

1.4.         Whirinaki.

2.        TAG members will provide a verbal update on each of these projects at the meeting.

Recommendation

That the Clifton to Tangoio Coastal Hazards Strategy Joint Committee receives the “Coastal projects update”

Authored by:

Simon Bendall

Coastal Hazards Strategy
Project Manager

Approved by:

Chris Dolley

Group Manager Asset Management

Attachment/s

There are no attachments for this report.

Clifton to Tangoio Coastal Hazards Strategy Joint Committee

22 February 2022

Subject: Coastal Ecology Workstream

Reason for Report

1.        This report presents a gap analysis undertaken as the first phase of work under the Coastal Ecology Workstream.

Background

2.        The adaptive pathways that have been developed and recommended by the Community Assessment Panels through the Strategy are proposed to reduce natural hazards risks for people, communities and infrastructure along the coast.

3.        Any action taken on the coast to reduce hazards risks is also likely to intervene in natural coastal processes, and has the potential to cause adverse environmental effects.

4.        As an example, Mana Whenua engaged in the Strategy development process have highlighted concerns about the potential for smothering of important ecosystems from beach nourishment activity.

5.        While natural character and environmental considerations were taken into account in the pathways development phase, we now (through work undertaken in the Design Workstream) have more information and detail on the potential physical works that would be required to implement the pathways.

6.        TAG seeks to ensure that the proposed pathways have been tested from a coastal ecological perspective, and that good baseline data is available to inform future assessments of environmental effects and resource consenting processes.

7.        The Coastal Ecology Workstream has been established under the Strategy for this purpose.

8.        With support from HBRC’s Anna Madarasz-Smith (Team Leader Marine & Coasts), Table 1 below has been developed to set out the key steps that form the Coastal Ecology Workstream.

Gap Analysis

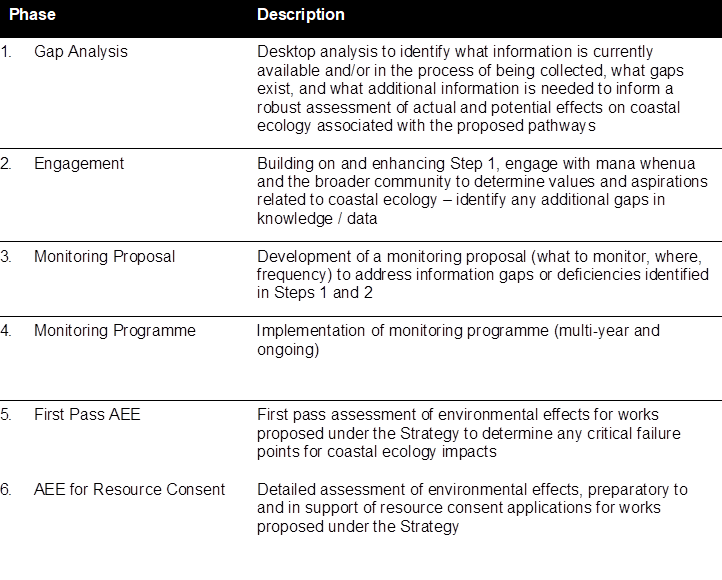

9.        The first task (as identified in Table 1) is to undertake a gap analysis, to determine the current state of knowledge about coastal ecology within the project area, and what new information would be required to allow a robust assessment of effects for the proposed works.

10.      Dr Shane Kelly from Coast & Catchment has been engaged to undertake this work.

11.      His report is provided as Attachment 1. Dr Kelly will be in attendance at the Joint Committee meeting to speak to his findings and respond to questions.

Table 1: Coastal Ecology Workstream structure and key tasks

12.      Dr Kelly’s report notes that there is a significant body of existing data and knowledge about coastal ecology in the Strategy area, however there are gaps, and for consenting purposes site and activity specific information will be required.

13.      The following potential effects / key issues / values areas are described and the state of knowledge and knowledge gaps for each noted:

13.1.      Smothering by deposited or redistributed sand and gravel

13.2.      Accelerating the spread and proliferation of marine pests

13.3.      Sediment suspension

13.4.      Burying benthic communities beneath structure

13.5.      Hardening of the shoreline

13.6.      Effects caused by changes in coastal processes

13.7.      Physical disturbance of the Coastal Marine Area (CMA) during construction

13.8.      Dune planting

13.9.      General effects on Ahuriri Estuary

13.10.    General effects on coastal vegetation

13.11.    General effects on birds

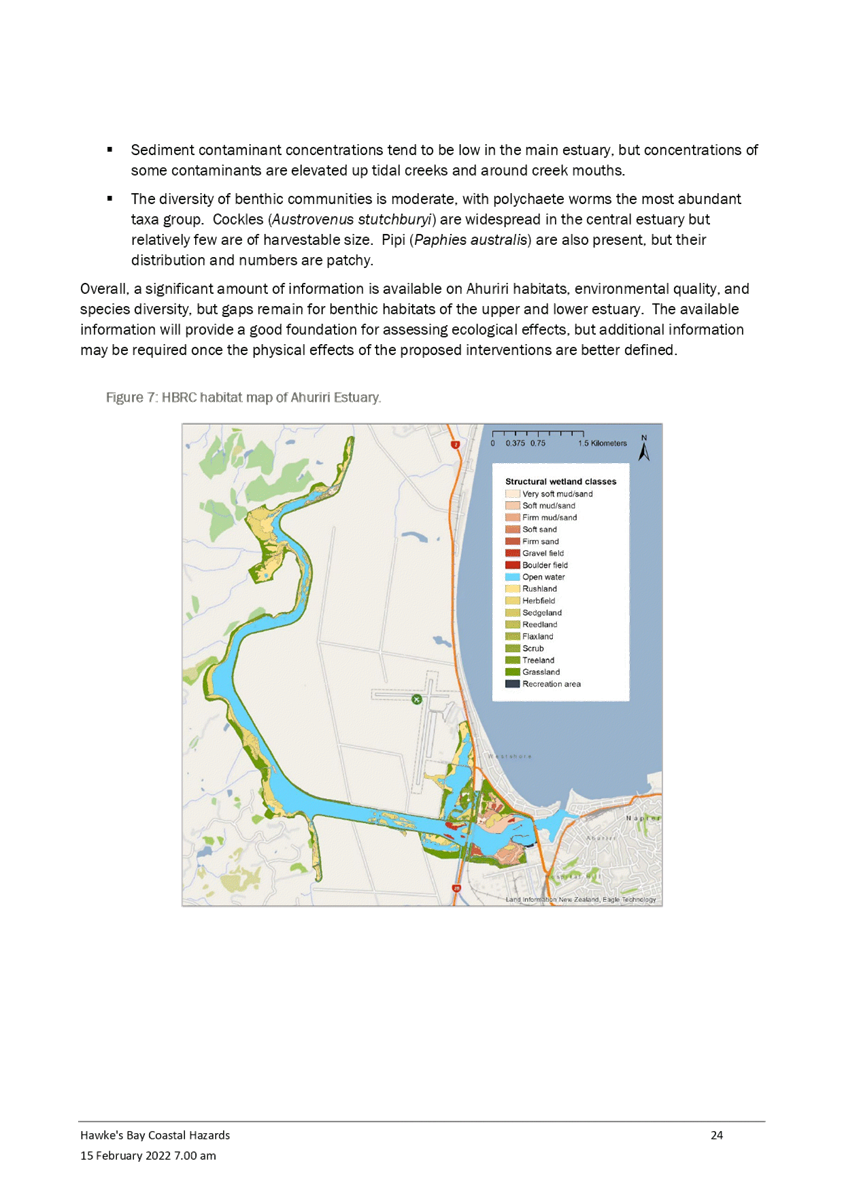

13.12.    General effects on fish

14.      The report notes that it will also be of critical importance to evaluate the cumulative impacts of the proposed interventions.

Next Steps

15.      With the completion of the gap analysis, TAG will now seek to commence the second phase of work (engagement) under the Coastal Ecology Workstream.

16.      This will enable a full suite of knowledge gaps to be identified, and a monitoring programme to be designed and implemented.

17.      Some of the challenges with engaging effectively are discussed in the Communications & Engagement paper included in this meeting’s agenda; given these challenges, timeframes to complete this phase are unclear at this time. Some discussions are being held with HBRC’s Kotahi project team, as there may be synergies with the community engagement proposed through that process. A further update on timing and programming for this workstream will be provided at the next Joint Committee meeting.

Recommendation

That the Clifton to Tangoio Coastal Hazards Joint Committee receives and notes the “Coastal Ecology Workstream” staff report.

Authored by:

Simon Bendall

Coastal Hazards Strategy Project Manager

Approved by:

Chris Dolley

Group Manager Asset Management

Attachment/s

1

Hawke's Bay Coastal Hazards - Ecological effects of mitigation measures: Phase 1, Gap Analysis

Hawke's Bay Coastal Hazards - Ecological effects of mitigation measures: Phase 1, Gap Analysis

Attachment 1

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

Clifton to Tangoio Coastal Hazards Strategy Joint Committee

22 February 2022

Subject: Discussion of Minor Matters not on the Agenda

Reason for Report

1.      This document has been prepared to assist Joint Committee members note the Minor Items Not on the Agenda to be discussed as determined earlier in Agenda Item 5.

Topic

Raised by
