Meeting of the Clifton to Tangoio Coastal Hazards Strategy Joint Committee

Date:                 Friday 19 November 2021

Time:                10.00am

Venue:

Virtually via Zoom

Agenda

Item        Title                                                                                                              Page

1.         Welcome/Karakia/Notices/Apologies

2.         Conflict of Interest Declarations

3.         Confirmation of Minutes of the Clifton to Tangoio Coastal Hazards Strategy Joint Committee held on 24 September 2021

4.         Call for Minor Items Not on the Agenda                                        3

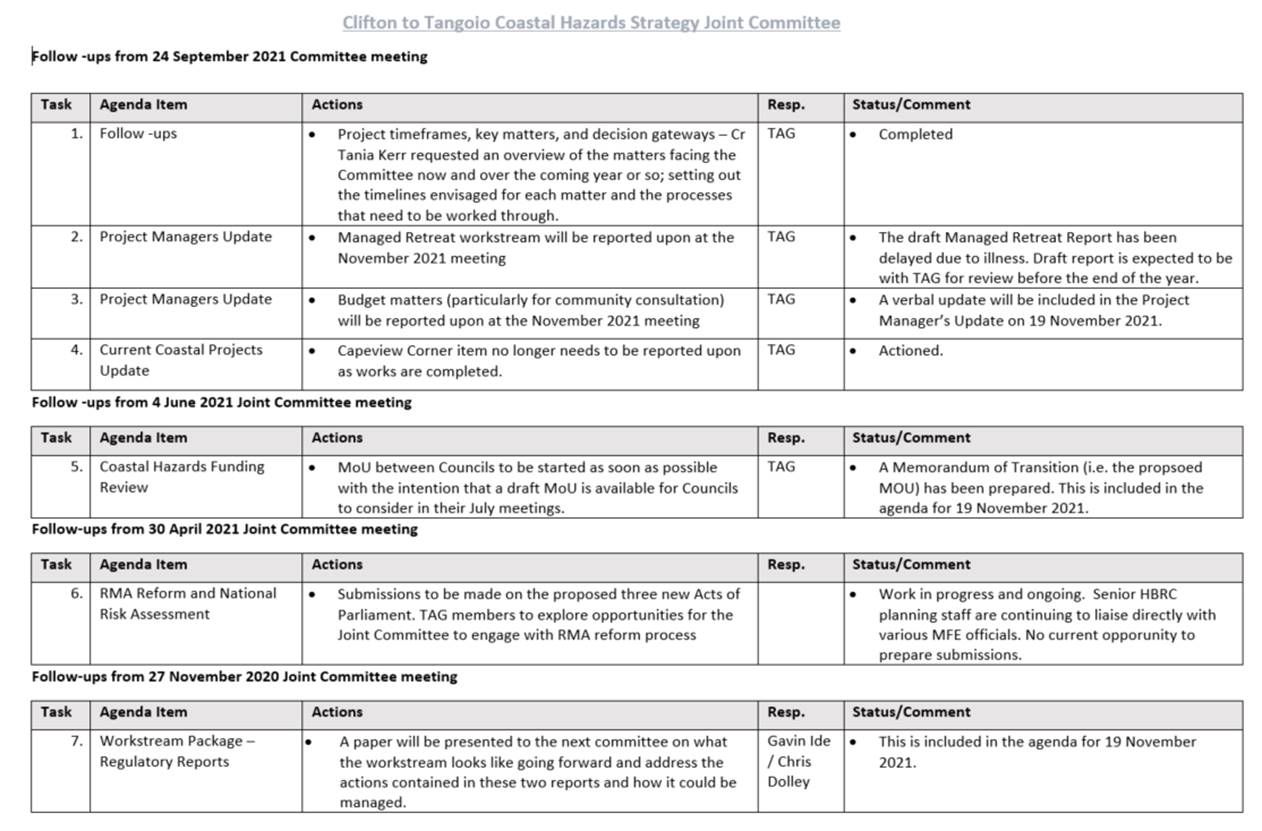

5.         Actions from Previous Clifton to Tangoio Coastal Hazards Strategy Joint Committee                                                              5

Information or Performance Monitoring

6.         Memorandum of Transition                                                           9

7.         Regulatory Workstream Next Steps                                            31

8.         Project Manager's Update                                                           37

9.         Communication and Engagement Update                                  39

10.       Current Coastal Projects Update                                                41

11.       Discussion of Minor Matters Not on the Agenda                        43

Clifton to Tangoio Coastal Hazards Strategy Joint Committee

Friday 19 November 2021

Subject: Call for Minor Items Not on the Agenda

Reason for Report

1.      This item provides the means for Joint Committee members to raise minor matters they wish to bring to the attention of the meeting.

2.      Hawke’s Bay Regional Council standing order 9.13 states:

2.1.   A meeting may discuss an item that is not on the agenda only if it is a minor matter relating to the general business of the meeting and the Chairperson explains at the beginning of the public part of the meeting that the item will be discussed. However, the meeting may not make a resolution, decision or recommendation about the item, except to refer it to a subsequent meeting for further discussion.

Recommendations

3.      That the Clifton to Tangoio Coastal Hazards Strategy Joint Committee accepts the following “Minor Items Not on the Agenda” for discussion as Item 11:

Topic

Raised by

Leeanne Hooper

GOVERNANCE LEAD

James Palmer

CHIEF EXECUTIVE

Clifton to Tangoio Coastal Hazards Strategy Joint Committee

Friday 19 November 2021

SUBJECT: Actions from Previous Clifton to Tangoio Coastal Hazards Strategy Joint Committee

Reason for Report

1.      To track items raised at previous meetings that require action, a list of outstanding items is prepared for each meeting. All action items indicate who is responsible for each, when it is expected to be completed and a brief status comment.

2.      Once the items have been completed and reported to the Committee they will be removed from the list.

Decision Making Process

3.      Staff have assessed the requirements of the Local Government Act 2002 in relation to this item and have concluded that, as this report is for information only, the decision-making provisions do not apply.

Recommendation

That the Clifton to Tangoio Coastal Hazards Strategy Joint Committee receives and notes the “Actions from previous Clifton to Tangoio Coastal Hazards Strategy Joint Committee Meetings” report.

Authored by:

Simon Bendall

Project Manager

Approved by:

Chris  Dolley

Group Manager Asset Management

Attachment/s

1

Actions for November 2021 meeting

Actions for November 2021 meeting

Attachment 1

Clifton to Tangoio Coastal Hazards Strategy Joint Committee

Friday 19 November 2021

Subject: Memorandum of Transition

Reason for Report

1.      This paper presents a draft Memorandum of Transition ("MoT”), which also includes as a schedule a draft Coastal Hazards Advisory Committee Terms of Reference (“ToR”), for consideration and endorsement by the Joint Committee.

Background

2.      All Partner Council’s have agreed in principle to the outcome of the Funding Review led by Raynor Asher QC.

3.      As the first phase of implementing the Funding Review outcomes, The Technical Advisory Group (“TAG”) have prepared a draft MoT.

4.      The purpose of the MoT is to provide a mechanism for Partner Councils to confirm the agreed arrangements for implementing the Clifton to Tangoio Coastal Hazards Strategy (“Strategy”) and the associated transfer of assets recommended by the Funding Review, and to provide the means for achieving HBRC’s Long Term Plan amendment process without objection from territorial authorities under s.16 of the Local Government Act.

5.      In developing the MoT, the Technical Advisory Group (“TAG”) have been working to the process and timeframe outlined in Table 1.

Table 1: MoT Development Process and Timeline

Task

Timing

1.     Drafting (with support from Simpson Grierson)

Throughout October

2.     Technical Advisory Group workshop on draft MoT

27 October

3.     Joint Committee workshop on draft MoT

5 November

4.     Joint Committee formally consider proposed MoT and recommend final draft MoT to Partner Councils

19 November

5.     Partner Council consideration / adoption of MoT

November / December

6.      The draft MoT is provided as Attachment 1 to this paper.

7.      Associated with the MoT, an Advisory Committee was recommended by Mr Asher to support HBRC’s functions as the lead agency for implementing the Strategy. This Advisory Committee will in effect replace the Joint Committee and provide for an ongoing forum for collaboration between tāngata whenua and the councils.

8.      A draft ToR for this proposed Advisory Committee is included as Schedule One to the draft MoT.

Next Steps

9.      Subject to direction from the Joint Committee, TAG propose to present the Joint Committee’s recommendations and the draft MoT and ToR to each Partner Council for consideration and feedback.

10.    Before the MoT can be formally adopted however, it must be circulated to all territorial authorities in the region for comment, to align with requirements under the Triennial Agreement. The territorial authorities are then provided with, at a minimum, 40 working days to respond. This time restraint under the Triennial Agreement could be varied through agreement between all the local authorities in the region, and TAG propose that this agreement is sought.

11.    It is also noted that Napier City Council and Hastings District Council have indicated that they will undertake targeted consultation on the proposed transfer of the Waimarama Seawall and the proposed Whakarire Ave revetment. This process can occur following the signing of the MOT.

Recommendation

That the Joint Committee:

1.     Receives and notes the “Memorandum of Transition” staff report.

2.     Endorses the draft Memorandum of Transition; and

3.     Recommends that the Hastings District Council, Napier City Council and Hawke’s Bay Regional Council confirm and execute the Memorandum of Transition, following satisfaction of all requirements under the Hawke’s Bay Region’s Triennial Agreement for the Triennium October 2019 – 2022.

Authored by:

Simon Bendall

Coastal Hazards Strategy Project Manager

Approved by:

Chris Dolley

Group Manager Asset Management

Attachment/s

1

Memorandum of Transition

Memorandum of Transition

Attachment 1

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

Clifton to Tangoio Coastal Hazards Strategy Joint Committee

Friday 19 November 2021

Subject: Regulatory Workstream Next Steps

Reason for Report

1.      This report presents a high-level outline of next steps/emerging opportunities to embed some of the recommendations of the Stage 4 Regulatory Workstream reporting into the one or more of the councils’ statutory planning documents.

Context

2.      The Strategy’s Stage 4 Regulatory Workstream reports[1] by Mitchell Daysh Limited in 2020 focused on two principal tasks:

2.1.      summarising key planning and regulatory documents that could impede or support implementation of the preferred pathways including a consideration of 'moral hazard’ risks; and

2.2.      summarising actions to ensure short-term adaptation responses can be implemented, including use of several case studies.

3.      In response to Mitchell Daysh Limited’s recommendations that focus on the policy and regulatory framework, this paper focusses on opportunities for amendments to planning documents under the RMA, i.e.:

3.1.      Hastings District Plan

3.2.      Napier District Plan

3.3.      Hawke’s Bay Regional Resource Management Plan (including the Regional Policy Statement) and

3.4.      Hawke’s Bay Regional Coastal Environment Plan.

4.      In particular, the MDL Policy and Regulatory Review had recommended that:

“amendments will be required to the Regional Coastal Environment Plan, the Hastings District Plan and City of Napier District Plan to ensure the objectives, policies and methods within these documents enable the outcomes sought by the Strategy. This is twofold –

[a]   greater recognition of the implementation of short-term hazard adaptation responses (including benefits) and

[b]   the avoidance of future land use intensification that will hinder long term delivery of the Strategy and increase moral hazard.[[2]]

Status of Councils’ RMA documents

Hastings DC

Napier CC

HBRC

Current Status

Operative District Plan.

Operative District Plan.

Operative combined regional plan, includes Regional Policy Statement (RRMP).

Operative Regional Coastal Environment Plan (RCEP).

Imminent status

Implementation of current plan.
No changes under preparation wrt coastal matters.

Draft District Plan in progress.  Notification as proposed plan in 2022.

Implementation of current RCEP.
Community engagement and options evaluation 2022-23 for ‘Kotahi.’

Medium-term activity

Post-notification proposed plan phase.

Notify ‘Kotahi’ plan before Dec 2024.

Review of HPUDS; Preparation of ‘Future Development Strategy’ for
Napier-Hastings Urban Area; Scoping Regional Spatial Strategy

Longer-term activity

Uncertain, subject to RM Reforms and associated transitional arrangements

5.      There are two key current or emerging opportunities for incorporating elements of the Stage 4 workstream recommendations into statutory planning documents:

5.1.      Review of Napier District Plan

5.1.1.   opportunity to embed provisions that support implementation of the Strategy (refer paragraph 4 above and Recommendation #4 in Attachment 1).

5.1.2.   could be inserted during the drafting phase (now to mid-2022) and/or via formal submissions after the new proposed district plan is publicly notified.

5.2.      Review of HBRC’s RMA plans (‘Kotahi’)

5.2.1.   involves a review of the Regional Policy Statement (RPS), Regional Coastal Environment Plan and the remaining parts of the Regional Resource Management Plan (refer paragraph 4 above and Recommendation #s 3, 4 and 5 in Attachment 1).

5.2.2.   timing wise, Kotahi programme is aiming for public notification as a proposed plan in late 2024.[3]

6.      Recommendations from the Strategy’s Stage 4 Regulatory Workstream have been added to the Kotahi project’s ‘to-do-list’ for the appropriate policy options evaluation, drafting and public consultation.

7.      HBRC’s 2021-31 Long Term Plan does not provide capacity for preparation of a stand-alone RPS/regional plan change embedding the Strategy earlier than the extensive Kotahi plan.

8.      There is some interest amongst HB Council leaders in the preparation of a high-level regional spatial plan, but no firm commitment nor resourcing of that initiative exists at present across the five HB councils. Preparation of a regional spatial plan is very likely to be further influenced by timing and content of the Resource Management system reforms.

Next Steps

9.      In terms of immediate next steps arising from the Regulatory [policy] Workstream, the Napier District Plan and the Kotahi Plan should remain the focus.

10.    Each of these are current and emerging opportunities to further embed relevant elements of the Strategy into statutory RMA planning documents.  That drafting can occur somewhat simultaneously with ongoing work on the remaining Stage 4 workstreams (e.g. design, funding, managed retreat and triggers in particular), plus the three Councils’ joint work on the Memorandum of Transition (MOT) and other associated transitional arrangements.

Resource Management System Reform and Local Government Review

11.    Government has signalled its intention to repeal the RMA and replace it with three new pieces of legislation:

11.1.    A Natural and Built Environments Act (‘NBEA’),

11.2.    A Spatial Planning Act (‘SPA’), and

11.3.    A Climate Change Adaptation Act (‘CCAA’).

12.    The Government has also proposed the creation of a National Planning Framework (‘NPF’) that would be a package of national policy directives and national regulations under the new system.

13.    Timeframes for introduction of Bills for the NBEA and SPA have slipped.  These are now ear-marked to be introduced in mid-2022 as Bills for Select Committee process.  Meanwhile, a Bill for the CCAA is now mooted to be introduced in 2023.  Transitional arrangements from the RMA-system to the new resource management system are currently unknown. These transitional arrangements will be critical if:

13.1.    the new system is to be an improvement over the current system and attain the goals of the reform; and

13.2.    the new system may offer timely cost-effective opportunities to further implement the Strategy.

14.    The Government has also established a Panel which is currently undertaking a review of local government arrangements.[4]  The Review Panel is expected to finalise its report and recommendations by April 2023.  It is too premature to speculate what (if any) of the Panel’s findings may then be progressed in any reshaping of local government.

Other points to note

15.    For now, roles and responsibilities for oversight and preparation/review of RMA planning documents are assumed to remain as they are at present.  It is noted that the draft MOT includes a specific clause to confirm that nothing is proposed to change with respect to these functions.

16.    Matters covered in this briefing paper would need revisiting after HBRC considers the matters arising and implications of transference of responsibilities for Strategy implementation.

Decision Making Process

17.    Staff have assessed the requirements of the Local Government Act 2002 in relation to this item and have concluded that, as this report is for information only, the decision making provisions do not apply.

Recommendation

That the Clifton to Tangoio Coastal Hazards Strategy Joint Committee receives and notes the “Regulatory Workstream Next Steps” staff report.

Authored by:

Gavin Ide

Principal Advisor Strategic Planning

Approved by:

Chris Dolley

Group Manager Asset Management

Attachment/s

1

Summary of Stage 4 regulatory workstream reports

Attachment 1 - Summary of Stage 4 regulatory workstream reports

Attachment 1

Clifton to Tangoio Coastal Hazards Strategy Joint Committee

Friday 19 November 2021

Subject: Project Manager's Update

Reason for Report

1.      In accordance with standing instructions from the Joint Committee, this report is provided in place of the written report required from the Project Manager under the Terms of Reference for the Joint Committee.

2.      It provides an opportunity for the Project Manager to present a verbal update to the Committee and answer any questions on general project matters including tracking against timeframes, milestone achievements and project risks. The Project Manager will provide a verbal update at the meeting.

Recommendation

That the Clifton to Tangoio Coastal Hazards Strategy Joint Committee receives the “Project Managers Update” report.

Authored by:

Simon Bendall

Coastal Hazards Strategy Project Manager

Approved by:

Chris Dolley

Group Manager Asset Management

Attachment/s

There are no attachments for this report.

Clifton to Tangoio Coastal Hazards Strategy Joint Committee

Friday 19 November 2021

Subject: Communication and Engagement Update

Reason for Report

1.      This report gives a brief overview of communications and engagement that has happened since the last Joint Committee meeting in September 2021.

2.      It outlines the changes to our proposed timing for engaging with the wider community ahead of formal consultation in early to mid-2022.

3.      It also provides an update on the process of engaging with mana whenua.

Executive Summary

4.      Communications and engagement for the Strategy has slowed due to the COVID-19 lockdown postponing our final panel workshop and limiting engagement opportunities with mana whenua.

5.      The timing for the Council-led pre-engagement activity proposed at the September Joint Committee meeting has changed to ensure we deliver an effective engagement approach.

Discussion

6.      Our next community workshop is scheduled for 8 December.

7.      This is the second community workshop held as part of the approach to developing signals, triggers and thresholds for the adaptive pathways developed under the Strategy.

8.      A newsletter update is scheduled to go out in mid-December and will feature the funding review updates, mana whenua engagement, community workshops, and this Joint Committee meeting.

9.      The Strategy continues to track towards a wider public consultation process in the first half of 2022.

10.    Ahead of this more formal process, TAG have been engaging in a range of pre-consultation planning. The purpose of pre-consultation is to facilitate information exchange, test ideas, and provide a lead-in to the formal consultation process to support informed participation.

11.    Members will recall that pre-engagement is proposed to occur in two parts: community-led, and council-led (in person and through digital channels).

12.    After the September Joint Committee, staff held an online meeting with some panel members to discuss the planned pre-engagement. Following this meeting and based on the questions raised and discussions within TAG, it was decided that more time was required to deliver the Council-led component to ensure it was comprehensive, engaging, and successful.

13.    This means that the Council-led pre-engagement proposed at the Joint Committee’s September meeting has been postponed until early 2022.

14.    It is still proposed to work with community workshop participants on community-led engagement pre-Christmas. We have had a range of feedback on how to effectively support and implement that process and will be working with community members over the coming weeks to confirm the approach. Feedback from that process is likely to be very useful to inform the Council-led engagement in 2022.

15.    Mana whenua engagement ahead of consultation has followed an extensive process with multiple approaches made (marae, taiwhenua, PSGE’s), though we have not had as much success as we had hoped for with only two hui held (Te Taiwhenua o Heretaunga at their Te Runanganui o Heretaunga hui and Matahiwi Marae). The impacts of COVID and a busy schedule for mana whenua have contributed to the limited uptake.

16.    This is an outline of the process we have followed to approach and engage with mana whenua:

16.1.    Sought advice from the Regional Planning Committee and Māori Committee on who we should engage with and how

16.2.    Identified groups – 3 Post Settlement Governance Entities (PSGEs), 2 taiwhenua, and 7 marae.

16.3.    Approached these groups by email with a follow up phone call offering to present and/or provide information about the strategy to a committee meeting, what we were asking of them, and to answer any further questions.

16.4.    Attended hui where invited.

16.5.    Sent a pre-recorded presentation through to groups we had not presented to.

17.    Acknowledging that we are now approaching a busy time of year, we propose to provide some space, and approach mana whenua again in the New Year to see if there is any further interest. This will align with the deferred Council-led pre-engagement discussed above.

Next Steps

18.    Key next steps before the end of the year include:

18.1.    Holding the final community workshop.

18.2.    Developing wider community engagement activities with panel members.

Decision Making Process

19.    Staff have assessed the requirements of the Local Government Act 2002 in relation to this item and have concluded that, as this report is for information only, the decision-making provisions do not apply.

Recommendation

That the Clifton to Tangoio Coastal Hazards Strategy Joint Committee receives and notes the “Communication and Engagement Update” staff report.

Authored by:

Rebecca Ashcroft-Cullen

Communications Advisor

Simon Bendall

Coastal Hazards Strategy Project Manager

Approved by:

Chris Dolley

Group Manager Asset Management

Attachment/s There are no attachments for this report.

Clifton to Tangoio Coastal Hazards Strategy Joint Committee

Friday 19 November 2021

Subject: Current Coastal Projects Update

Reason for Report

1.      This report provides an opportunity for the Technical Advisory Group (TAG) to provide an update on various coastal projects the Joint Committee has expressed an interest in keeping abreast of, namely:

1.1.      Whakarire Ave Revetment Works

1.2.      Extended consent area for sand deposition at Westshore

1.3.      Haumoana 18

1.4.      Whirinaki.

2.      TAG members will provide a verbal update on each of these projects at the meeting.

Recommendation

That the Clifton to Tangoio Coastal Hazards Strategy Joint Committee receives the “Coastal Projects Update”

Authored by:

Simon Bendall

Coastal Hazards Strategy Project Manager

Approved by:

Chris Dolley

Group Manager Asset Management

Attachment/s

There are no attachments for this report.

Clifton to Tangoio Coastal Hazards Strategy Joint Committee

Friday 19 November 2021

Subject: Discussion of Minor Matters Not on the Agenda

Reason for Report

1.     This document has been prepared to assist Joint Committee members note the Minor Items Not on the Agenda to be discussed as determined earlier in Agenda Item 4.

Item

Topic

Raised by

1.

2.

3.

[1]      Mitchell Daysh Limited, July 2020, Policy and Regulatory Review: Stage 4 Clifton to Tangoio Coastal Hazard Strategy at https://www.hbcoast.co.nz/assets/Document-Library/Other-documents/NO-WATERMARK-Policy-and-Regulatory-Review-report-for-Stage-4-of-Clifton-to-Tangoio-Coastal-Hazard-Strategy-2120-FINAL-DRAFT-July-2020-5477.pdf

        Mitchell Daysh Limited, July 2020, Consentability of short-term adaptation responses: Stage 4 Clifton to Tangoio Coastal Hazard Strategy 2120 at https://www.hbcoast.co.nz/assets/Document-Library/Other-documents/NO-WATERMARK-Consentability-of-short-term-adaptation-responses-report-for-Stage-4-of-Clifton-to-Tangoio-Coastal-Hazard-Strategy-2120-FINAL-DRAFT-July-2020.pdf

[2]      ‘Moral hazard’ can be defined as a situation where an individual has an incentive to increase their exposure to risk because they do not bear the full costs of that risk or that risk can be passed on.  In the present context, an example of moral hazard would be purchasing or developing property along the Clifton to Tangoio coastline in the knowledge that the in the short-term, the Council(s) intend to install coastal protection measures for which they will not have to bear the full costs.

[3]      31 December 2024 timeframe is fixed in order to comply with legal requirements for freshwater-related planning content.

[4]      In April 2021, Local Government Minister Hon Nanaia Mahuta appointed a panel and tasked it with considering what local government does, how it does it, and how it pays for it. From there, they will explore what local government’s future looks like, including roles, functions and partnerships; representation and governance; funding and financing.  In September 2021, the Panel issued an interim report. This will now be followed by a draft report for public consultation in September 2022, and a final report by April 2023.
